Aggregator
Program Deputy Summary, presented 2026-10-30
COMPLETED 1L07 JT stem assembly replacement
COMMENT ON 1L07 JT stem assembly replacement
Removed and swapped JT stem assembly with a new one. I didn't see any issue with the pulled stem assembly or the seat inside the end can.
Reinstalled JT actuator & set the seating force & LVDT position indicator and verified valve closure. Circuit held 8psi / no bleed down over a 24-hour period.
COMMENT ON SAM26 PSS replace the ILD air cylinder actuator
COMMENT ON install labjack(T7) in injector for wien monitoring
COMPLETED B-36 Replace damaged breakers
Hall D - Daily report
COMPLETED SAM 26 Pene. Emptying Requests
COMMENT ON 2026 SAM LCW Controls Calibrations
C100-02R Acceptance Testing Swing Shift
Completed Tuner characterization for cavity 6.
Then did the gradient ramp for cavity 6. Emax at 20.8 MV/m MV/m - CARM (gamma) limited
FE Onset at ~12.5 MV/m
Max dose rate ~ 6 R/hr at 20.8 MV/m
Attempted one hour at 20.8 MV/m.
Completed FE vs E measurement
COMMENT ON Install 8 kW circulators in 1L09

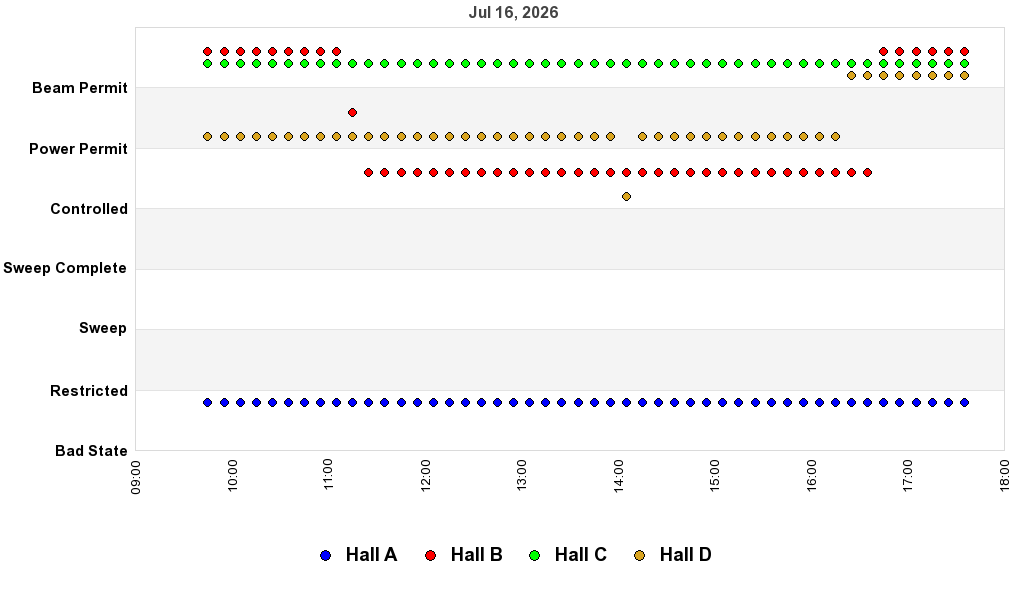

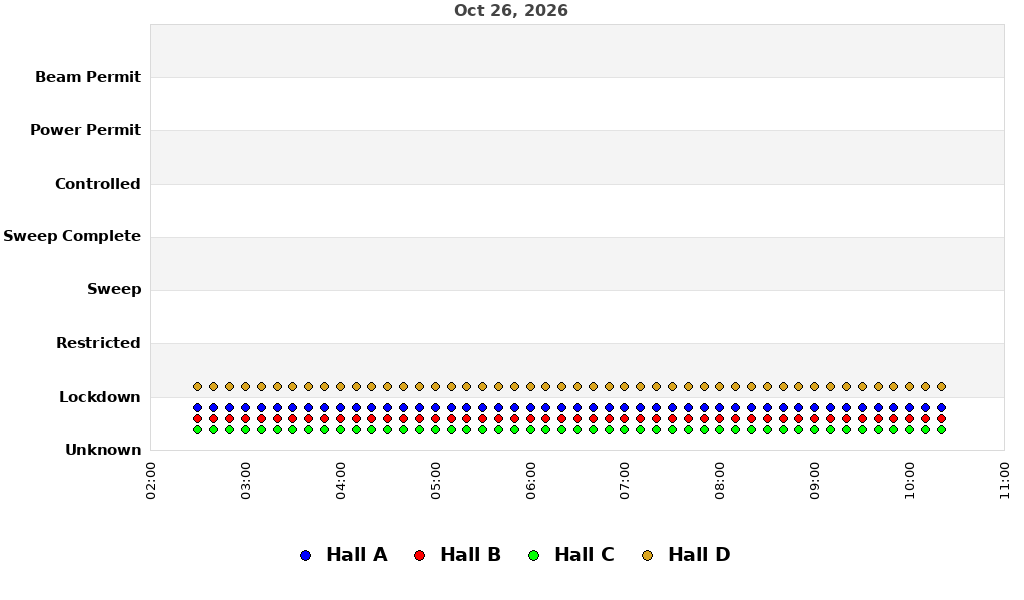

ATLis Comments Daily Digest
ACG Report
Created and populated hasPSSInterlock CED property to support creation of PSS Certification "Beam Destinations" in SRM/HCO.
Moeller Halo Monitor Controls Hardware testing
MOLLER install 10/29/2026
•Moved two MPS shielding blocks.
•Transport the MPS IC electronic rack to hall
•Worked on the upstream beamline girder and adjusted with shims.
•Target group doing leak detection on h2 piping expect to be done next week.
• Mapping of the TM0.
Cryogenics Update
Installed liquid nitrogen dewar #2 relief valves
Started cleanup of CHL2 SCN 2K cold box process piping
Crane scheduled for next Thursday to install CHL2 SCN cold box lid.
Installed additional relief valves on CHL2 vertical cold box
Continued removing racks from CHL control room, assembled second workstation table, and ran conduits.
COMMENT ON Extending Laser beam Passthrough of CEBAF Laser Room
COMMENT ON Magnet Thermal Interlock Chassis Upgrade
Hall C daily summary
Today Hall C technicians worked on.
Removing downstream beam line from target to gate-valve. with rad-con support.
Assembling filament extrusion project.
Meeting about NUCAT modifications.
Assembling welding paperwork package for weld examination.
Cross division work for Friday will be Fork lift practical with Facility's.
COMMENT ON SAM26 PSS replace the ILD air cylinder actuator
This task is now approved in the ePAS system. Need to schedule the best time to perform this task. While not in the direct area of ongoing work in the NL it is in the path to access those areas. we would need approximately one full day to perform this task if all goes as planned. Would like to perform this task next week if scheduling permits.
